Project Timeline

Milestones and expected completion dates for India’s semiconductor facilities

Published

October 5, 2026

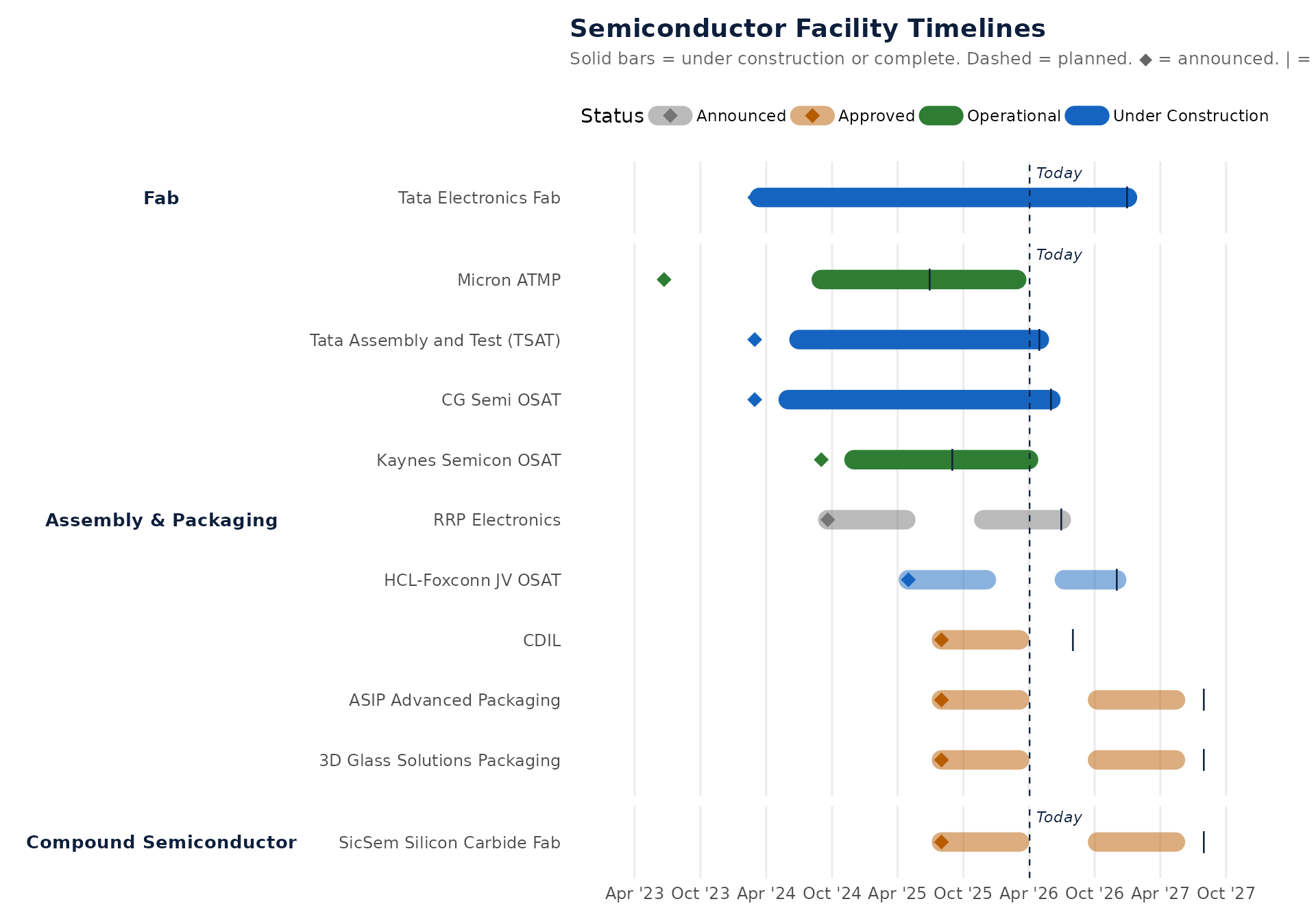

Facility Timelines

Each row represents a facility. Bars show the span from construction start (or announcement, if construction hasn’t begun) to expected or actual completion. Diamond markers (◆) mark the announcement date. Vertical ticks (|) show the original target completion date where known. The dashed line marks today.

Research and strategic facilities (SCL Mohali, GAETEC, IISc MNNFC) predate the ISM timeline and are not shown here — see the main table for the full list.

Key Dates

Source Library
